132/11.5 kV consumer grid stations

From load requirement to an energized asset.

Unirazz Services brings studies, authority coordination, detailed engineering, procurement, civil and electrical construction, testing and commissioning together under one accountable EPCC delivery structure.

Company milestone Pakistan’s first commercial-tariff consumer grid station delivered through integrated EPCC capability.
Unirazz Services consumer grid station engineering, procurement, civil works, installation, testing and commissioning methodology
EPCC Engineering · Procurement · Construction · Consultancy
01 Feasibility & studies 02 DISCO coordination 03 Turnkey execution 04 Energization & handover
When a consumer grid station is required

A dedicated grid connection for major consumers.

The consumer grid station route applies where the sanctioned load, tariff category and utility interconnection requirement call for dedicated high-voltage infrastructure.

The methodology addresses industrial consumers under Tariff B4, commercial developments and malls under Tariff A2c, and housing societies under Tariff H, with the final scheme governed by the applicable DISCO requirements and approved load allocation.

Industry Commercial & malls Housing societies
Consumer grid station categories including industry, commercial developments and housing societies
Application context Consumer categories and dedicated grid requirements
Proven commercial-tariff delivery

A first-of-its-kind grid station milestone in Pakistan.

Unirazz Services is the first EPCC—Engineering, Procurement, Construction and Consultancy—firm to deliver Pakistan’s first commercial-tariff consumer grid station. That experience strengthens every decision from grid studies and scheme finalization to equipment integration, construction, commissioning and utility handover.

Seven-phase methodology

A controlled path from concept to service connection.

Every phase closes defined technical, regulatory, commercial and construction interfaces before the project advances to the next critical milestone.

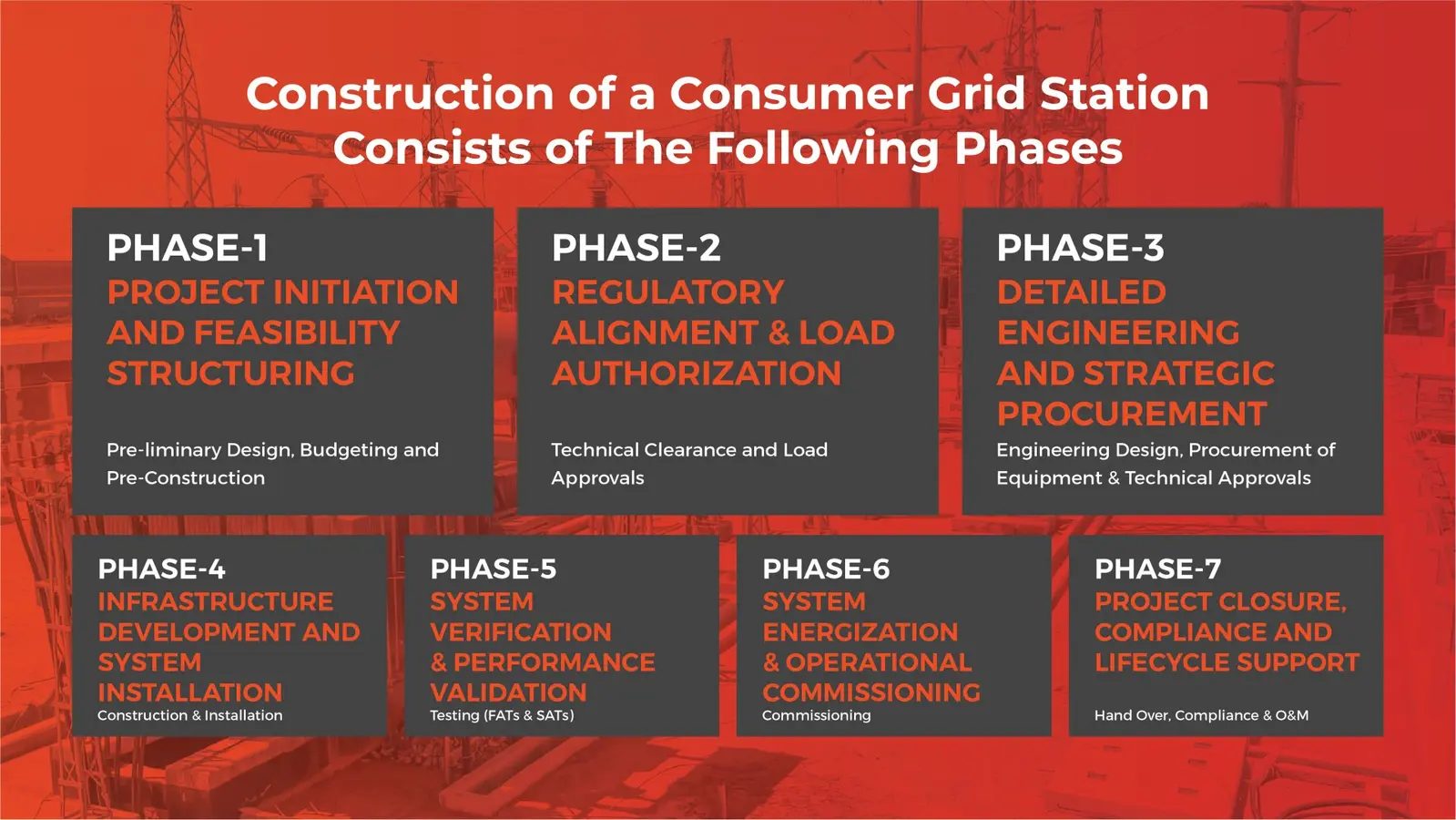

Seven phases for construction and commissioning of a consumer grid station
At a glance The complete consumer grid station delivery sequence
  1. 01
    Preliminary design · budgeting · pre-construction

    Project initiation & feasibility structuring

    Define the load objective, boundaries, site constraints, delivery model and information required to convert the requirement into a technically and commercially structured project.

    • Load data, utility interface and scope definition
    • Topography, site selection, contours and route profiling
    • Preliminary layout, budget, schedule and enabling works
  2. 02
    Technical clearance · load authorization

    Regulatory alignment & load authorization

    Coordinate the application route, approved load, point of interconnection, service-connection requirements and authority submissions so that engineering proceeds against an agreed utility scheme.

    • DISCO planning, design and operations coordination
    • Load allocation and interconnection-scheme alignment
    • Required environmental, inspector and statutory clearances
  3. 03
    Engineering design · equipment procurement

    Detailed engineering & strategic procurement

    Translate the approved scheme into coordinated primary, secondary, civil, control and protection designs, then procure compliant long-lead equipment against controlled technical specifications.

    • SLD, layouts, foundations, earthing, protection and control
    • Specifications, BOQ, bid evaluation and deviation control
    • Vendor drawings, type tests, manufacturing and FAT planning
  4. 04
    Construction · installation

    Infrastructure development & system installation

    Execute the civil, structural, line and electrical works through an integrated programme with disciplined HSE, QA/QC, interface management and progress control.

    • Site development, control building, foundations and trenches
    • Transmission interconnection, earthing and steel structures
    • Equipment erection, cabling, panels and auxiliary systems
  5. 05
    FAT · SAT · performance validation

    System verification & performance validation

    Confirm that every asset, interface and protection function meets the approved drawings, specifications, utility requirements and safe-energization criteria.

    • FAT and type-test review, inspections and site testing
    • Protection, metering, control, SCADA and interlock checks
    • Calibrated records and ready-for-energization recommendation
  6. 06
    Commissioning · staged loading

    System energization & operational commissioning

    Prepare and control the switching sequence, energize the installation in approved stages and demonstrate stable operation in coordination with the utility and the client.

    • Service-connection order and energization readiness
    • Switching plans, staged loading, monitoring and logs
    • On-load commissioning and operational endorsement
  7. 07
    Handover · compliance · O&M

    Project closure, compliance & lifecycle support

    Close the project with a complete technical record, trained operating personnel and a structured path for warranty, defects-liability and long-term asset support.

    • As-built drawings, test dossiers and authority correspondence
    • O&M manuals, training, spares, tools and software handover
    • Punch closure, warranty records and lifecycle support
Grid station studies

Technical decisions made before concrete and equipment.

Unirazz Services offers best-in-class study capability from grid requirement and interconnection finalization to equipment duty, protection philosophy and approval-ready engineering.

01

Load-flow studies

Voltage profile, transformer loading, losses, reactive demand and operating scenarios.

02

Short-circuit studies

Fault levels, equipment duties, breaker ratings and network contribution checks.

03

Protection coordination

Relay philosophy, settings, grading, interlocks, trip logic and utility coordination.

04

Earthing & safety

Grid design, soil resistivity, touch and step potentials, bonding and lightning protection.

05

Insulation coordination

System insulation levels, surge protection, clearances and equipment interface checks.

06

Layout & route engineering

Site optimization, bay arrangement, cable routes and transmission-line profiling.

07

Specifications & BOQ

Performance-based requirements, quantities, interfaces and measurable acceptance criteria.

08

Scheme finalization

Technical submissions, comments closure and coordination through final utility acceptance.

Constructible and programme-controlled

All required delivery capabilities under one EPCC structure.

One-point coordination reduces design gaps, procurement delays and site-interface conflicts across the critical path.

01System studies & engineering
02Authority liaison & approvals
03Equipment procurement & logistics
04Civil, structural & line works
05Electrical erection & cabling
06HSE, QA/QC & project controls
07Testing & commissioning resources
08Documentation, training & O&M
StudyApproveEngineerProcureConstructTestEnergizeHandover

Early interface mapping keeps authority approvals and long-lead equipment on the critical path, while coordinated engineering and site planning make the grid station constructible within the requisite timeline.

Methodology highlights

From feasibility to energized operations and support.

Selected methodology views show how early project structuring connects directly with commissioning, handover and long-term operational readiness.

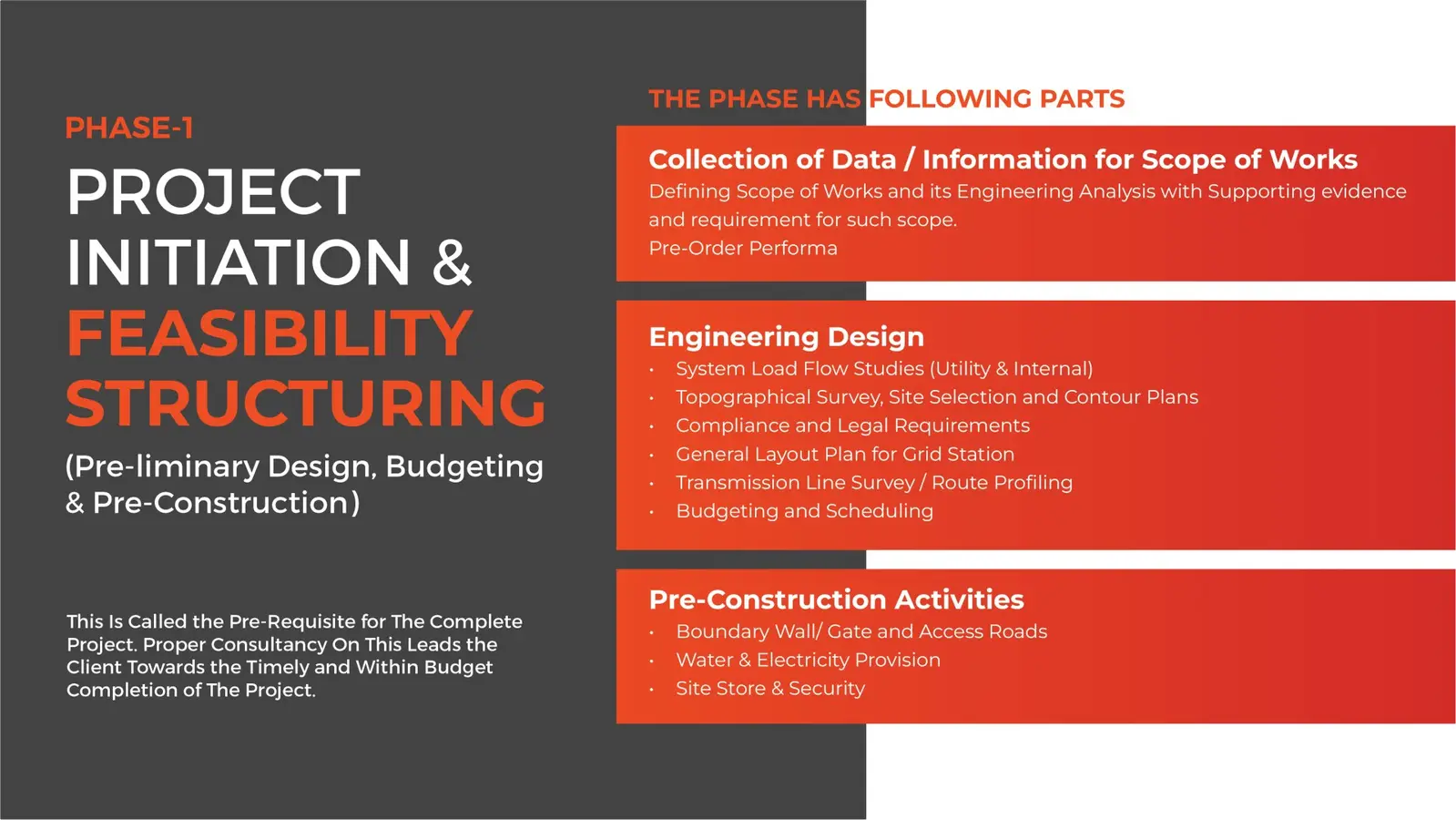

Project initiation and feasibility structuring methodology
Phase 01 Feasibility, engineering inputs and pre-construction preparation
System energization and operational commissioning methodology
Phase 06 Energization and operational commissioning

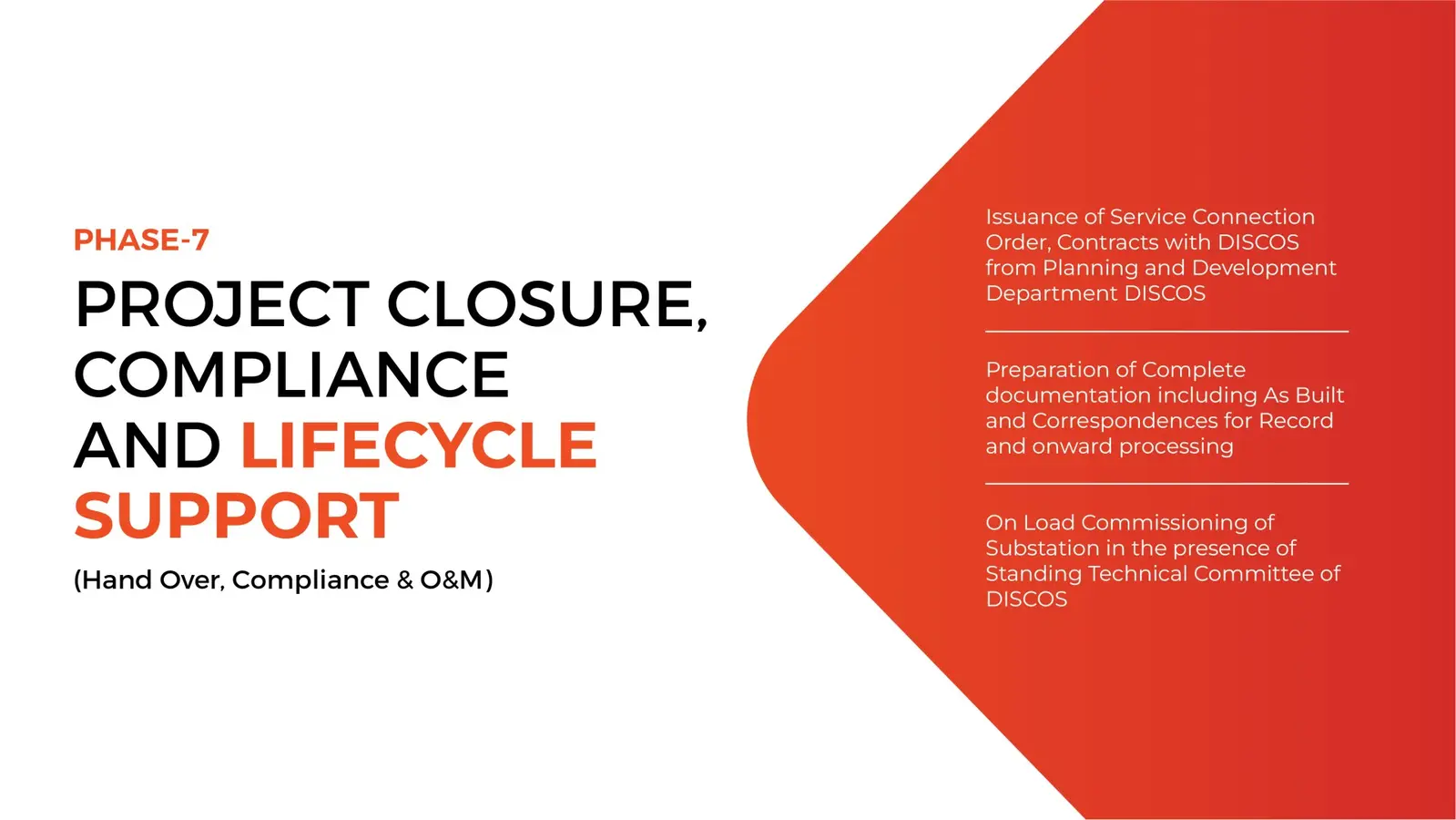

Project closure, compliance and lifecycle support methodology
Phase 07 Handover, compliance and lifecycle support
Pre-offer scope definition

The right information makes the programme reliable.

Before pricing or mobilization, Unirazz structures the client’s technical, site, procurement and contractual inputs into a controlled scope. This reduces assumptions, prevents interface gaps and allows realistic design, procurement and completion planning.

Start a scope discussion
01

System configuration

Approved load, transformer and line bays, spare bays, capacitor banks, completion period and future expansion.

02

Land, surveys & approvals

Soil investigation, contours, topography, site layout, route survey, technical clearance and environmental approvals.

03

Design responsibility

Primary, secondary and civil design boundaries, BOQ ownership, client criteria and submission responsibilities.

04

Equipment strategy

Transformer, switchyard, protection, MV, telecom, cabling, earthing, DC system and country-of-origin preferences.

05

Execution & assurance

FAT and local inspection responsibility, utilities, labour facilities, HSE, security, insurance, testing and commissioning.

06

Interconnection & commercial

Transmission-line or deposit works, procurement route, payment instruments, guarantees, retention and agreed terms.

Consumer grid station requirement?

Make the scheme approvable, constructible and ready to energize.

Bring Unirazz Services in early to align studies, approvals, design, procurement and construction around one delivery programme.
